Multimodal Transport of 5 RMGCs

Multimodal Transport of 5 RMGCs

rail-mounted gantry crane parts being positioned on trailer

UTC Global Logistics

COMPLETES MASSIVE MULTIMODAL TRANSPORT

UTC’s global network recently coordinated the transport of five rail-mounted gantry cranes from China to USA.

A total of 30,000 cbm of cargo shipped from Taicang, China on four part-charter vessels to Houston, TX, Cleveland, OH, and Burns Harbor, IN, USA. The project included 168 out-of-gauge pieces, along with parts and accessories, totaling 2,776 tons of freight.

breakbulk pieces
tons of freight
CBM of cargo

Complex logistics projects require innovative solutions – and that’s just what UTC is known for. When a global client reached out to UTC's Finland office to design a customized logistics plan to transport five rail-mounted gantry (RMG) cranes from Taicang, China to Indiana, USA, our team immediately started working on the quickest, most cost-effective solution.

UTC was awarded the project and within two weeks, cargo was moving towards its destination.

Project planning is critical to the success of a complex multimodal move of over 30,000cbm of cargo. When UTC Finland was approached, they immediately engaged UTC’s global network to develop a logistics strategy. Initially, the plan was to ship all cargo to Houston, utilize rail for containerized cargo, and transport the oversized cargo upriver by barge to the final destination, but this was not possible due to channel closures and several other factors. The plan required further adjusting when the client needed the cranes transported in larger pieces for quicker assembly upon delivery.

After tailoring a logistics strategy that optimized transport of over-dimensional cargo and delivery sequencing, UTC set its plan in motion.

UTC split the 2,776 tons of cargo originating in Taicang, China, into four part-chartered shipments. Two heavy-lift vessels would transit the Great Lakes to Burns Harbor, Indiana, USA, to discharge the largest over-dimensional components, and continue on to Cleveland, Ohio, USA to offload containerized parts and accessories. Other large components compatible with rail transport were shipped to Houston, Texas, USA via a third and fourth part-charter heavy lift-vessel.

part-charter vessels
barges
truckloads
railcars

As the cargo loaded in China, UTC’s team in Houston worked to obtain rail clearances urgently. Clearances for over-dimensional cargo can be challenging to get under normal circumstances, but UTC’s in-depth discussions and pre-planning allowed for fast-tracked approval.

The largest pieces, five crane trolleys (21m x 6.6m, weighing approximately 70 metric tons), went to Burns Harbor, IN. UTC worked with local partners to find a suitable location for barge offloading and mobilized a 500-ton crane capable of lifting the over-dimensional pieces.

beams WP

Upon arrival, these pieces were discharged directly from the ship onto three barges for last-mile transport (pictured below). At the final job site, SPMTs were used to unload the equipment from the barge.

IMG_5829
IMG_7584
IMG_7590

The cargo shipped to Houston required over 60 rail cars to reach its final destination.

Once the cargo arrived in Houston, we were moving at double-speed. UTC’s Rail logistics team arranged for the dedicated railhead to receive the cargo directly from the heavy-lift vessel. Once these were lined up, the cargo was offloaded over the course of a few days and was then on its way,” recalls JoAnn Zelaya, UTC’s Director of Rail, Rigging & Heavy Haul.

The volume of cargo, along with its oversized nature, meant that dozens of rail cars would be needed. These large components weighed in at 70 metric tons, but their out-of-gauge nature – very long and tall pieces – required shallow cars to meet rail clearances.

UTC’s team had multiple in-depth discussions with the railroads to find the most economical route for the cargo volume.

By consolidating all rail loads to two special, dedicated trains, we brought transit time for all pieces down to 4-5 days. This allowed the job site to optimize their setup and equipment for expedited unloading and assembly of the cranes in an extremely efficient manner, significantly decreasing the construction timeframe. Other plans submitted to the customer required weeks or months of individual deliveries, and even more time for assembly after that,” says Juha Karmanto, Sales Director UTC Finland.

beam and gantry 2
beam and gantry
Global IV Intermodal Container Crane Project_Moment 1.39.45

UTC’s approach puts us ahead of the competition.

A complex, multimodal logistics project like this is a great example of UTC leveraging its global network and in-house expertise to add value for our customers. Our team developed a unique, cost-effective logistics solution that differentiated us from the competition. Furthermore, it is these kinds of dynamic projects, with multiple shipments, where UTC showcases its high level of communication and coordination skills. We worked with multiple railroads and the receiver to arrange the use of dedicated trains, separate shipments of over 30 cars each, going out of Houston directly to the final jobsite. Sourcing and coordinating the deployment of the right cars in such a large quantity was an onerous task, but fortunately UTC’s team of skilled operators are well versed in these types of projects,” says Jim Lange, Project Director.

20200713_084808

UTC’s global team worked hand-in-hand with the customer, providing real-time updates during the project. Andrew Johnson, Project Supervisor, was appointed the direct North American contact during this project. Coordinating with UTC’s local offices in Finland, China, and the USA, he worked directly with the site construction team to ensure constant communication and smooth delivery.

We were able to provide the customer with a fine-tuned logistics strategy and direct communication that minimized the timeframe between purchase and implementation,” says Matt Loll, VP Project Development, North America. “UTC’s customers can always rely on having direct contact with UTC’s global network.”

UTC's rail logistics team has specialized knowledge of your equipment, allowing us to provide the most innovative and cost-saving logistics solutions.

Check out UTC's Project Showcases & Industry Insights:

UTC sets new standard for ro-ro charters

UTC arranged an air charter & last mile transport for 3 aero-derivative gas turbines from Egypt to Chicago, Illinois, USA, supporting multiple power stations.

Time-sensitive air charter

UTC arranged an air charter & last mile transport for 3 aero-derivative gas turbines from Egypt to Chicago, Illinois, USA, supporting multiple power stations.

UTC Sets New Heavylift Record

utc overcomes mounting challenges for greenfield project in colombia UTC’s global heavy lift experts coordinated the transportation of the heaviest cargo ever mobilized on Colombian roads. Over the last two years, a team of UTC Overseas professionals has been transporting the equipment needed to operate the new El Tesorito power plant in Cordoba Province, Colombia. Having worked on many greenfield projects before, these specialists had the knowledge, experience, and contacts to arrange ocean transport, loading and unloading, port manipulation, storage, on-carriage, and discharge onto the foundation. 11 gen-sets Heaviest Piece: 300 tons Additional 400 containers Diligent planning and precise execution…

+100K FRT GLOBAL CEMENT TRANSPORT

UTC’s Global Cement Division managed the transport of over 100,000 freight tons of equipment for one of the largest cement plants in the USA. Multiple modalities were used for hundreds of shipments, some with pieces over 25′, arriving from China, India, Germany, Italy, Romania, Turkey, Egypt, and Mexico. 100,000 freight tons 37 hopper barges 150 truckloads With equipment heights over 25ft, the main transportation challenge was shipping major components in the largest configuration possible. Planning began in 2019 with detailed route and feasibility studies, risk assessments, and evaluation of discharge ports. Transporting equipment to the job site, located deep in…

Industry Update Aug 2022

Inflation, impending strikes, military drills and droughts are making it more difficult to navigate the international supply chain. Here’s what you need to know today.

July 2022 Industry Update

Worldwide labor negotiations and port congestion are taking hold as the peak shipping season approaches. Here’s what you need to know today.

Industry Update June 2022

With international and local expertise, diligent risk assessment, and multi-modal capabilities, our teams will work with you to keep your cargo moving. Contact UTC today to develop a transportation strategy that works best for you.

Industry Update April 2022

With international and local expertise, diligent risk assessment, and multi-modal capabilities, our teams will work with you to keep your cargo moving. Contact UTC today to develop a transportation strategy that works best for you.

256MT Crane Transport

UTC Manages 256MT Crane Transport: No Assembly Required UTC recently coordinated the transport of a Gottwald Mobile Harbor Crane from Texas to Florida. By thinking outside the box, UTC’s Heavy Equipment Team developed a solution to transport the crane fully assembled, in a fraction of the time. 256 MT 130 ft tall 5 days UTC rolls on and rolls off fully assembled Gottwald Crane UTC routinely transports oversize, overweight cargo, but this move was different. The 256 MT Gottwald Mobile Harbor Crane that stands 130′ high was driven directly onto a barge for a five-day trip from Brownsville, Texas, to…

Breaking News

“The goal is, let’s have this transition, which let’s face it, is massive to accomplish, without stranding workers, without stranding communities,” said Moniz, who spoke at Houston Maritime Center upon being presented the HMC Maritime Education Award in early March. “And for that to work we have to put the people to work that have the skillset.”

Read More

Nine Genset Multimodal Delivery

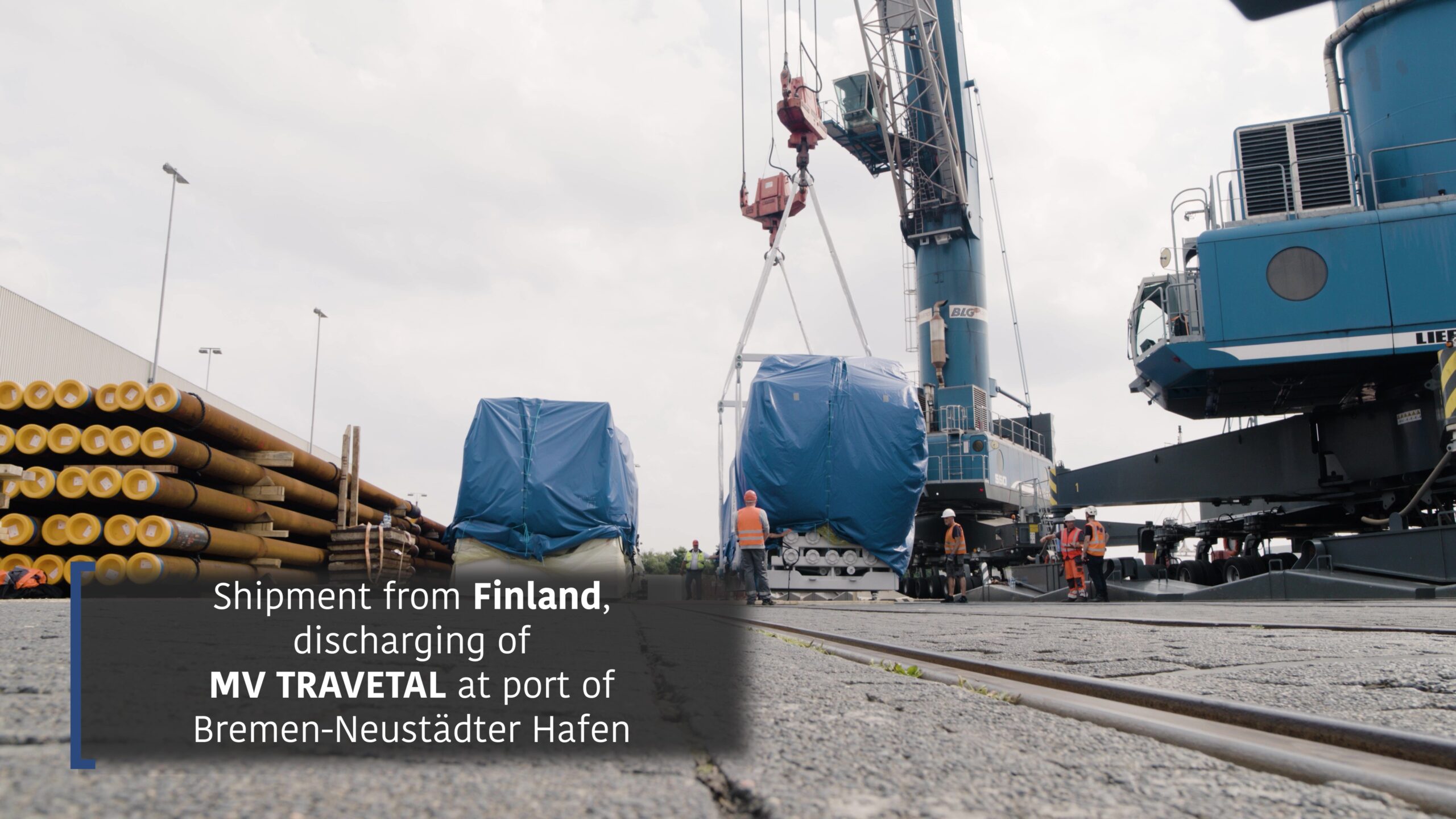

cranes lifting genset at final jobsite onto SPMTs, multimodal delivery
